Crane Services for Pharmaceutical Facility Construction: What the Build Requires

Grove crane lifting steel beams at a construction site under clear blue skies.

Building a pharmaceutical or life sciences manufacturing facility means moving structural steel, large process equipment, and rooftop mechanical systems on a schedule that rarely allows for delay. Crane services for pharmaceutical facility construction cover that entire build-phase lifting program, from the first structural steel pick to the final skid-mounted system landing on its pad. This guide focuses on what happens during construction, not the permanent cleanroom cranes installed once a facility is operating.

Key Takeaways

  • Crane services for pharmaceutical facility construction cover the build phase: erecting structural steel, setting large process equipment and tanks, placing rooftop MEP, and landing modular or skid-mounted systems. That is different from the permanent cleanroom overhead cranes installed for in-operation use.
  • Crane class depends on more than tonnage. Reach over an enclosing structure, ground conditions on an unfinished site, and tight-tolerance placement all factor into the pick, which is why crane selection on these builds is an engineered decision, not a catalog one.
  • More than $480 billion has been pledged across 22 new U.S. pharmaceutical manufacturing sites, with Section 232 deadlines on July 31 and Sept. 29, 2026 compressing build schedules.
  • Life sciences capital spending grew 13% per year from 2022 to 2024, with more than $150 billion in new capital projects announced before 2030.
  • Modular and skid-mounted, prevalidated systems increasingly arrive on-site ready for placement, which shifts heavy-lift work earlier in the schedule and raises the stakes on precise, single-pass picks.
  • A coast-to-coast crane rental provider with in-house engineering support can coordinate a multi-site pharma build program under one plan instead of managing separate providers at each location.

Build Phase vs. Permanent Cleanroom Cranes

Crane services for pharmaceutical facility construction cover the heavy lifting done to build the plant itself: erecting structural steel, setting large process equipment, placing rooftop MEP, and landing modular or skid-mounted systems. That is a separate scope from permanent cleanroom overhead cranes, the stainless bridge, gantry, and workstation systems installed inside a finished, operating cleanroom to move materials during production.

Search results and AI answers on this topic often blend the two together, which creates a real risk of miscommunication early in a project. A general contractor or owner’s rep planning the build phase needs a crane rental and heavy-lift partner. A cleanroom equipment manufacturer supplies the permanent installed systems that come later.

Maxim Crane works the build phase: the structural steel, process equipment, rooftop mechanical, and modular placement that happens before the facility is ever operational, backed by a refreshed fleet at 60+ locations across the country.

Why the Pharma and Life Sciences Build Wave Is Accelerating

Pharmaceutical manufacturing construction in the United States has shifted from a strategic talking point to active, tariff-driven build-out in 2026, and the timelines behind that shift are tight. More than $480 billion has been pledged across 22 new U.S. manufacturing sites and roughly 44,000 new jobs, with Section 232 deadlines landing on July 31, 2026 for Annex III firms and Sept. 29, 2026 for others. Those deadlines are compressing construction schedules across the industry.

Named build locations concentrate in North Carolina, New York, New Jersey, and Indiana, among other states, which supports a national, coast-to-coast crane rental footprint over a single-region provider.

The capital behind these projects reflects the same acceleration. Life sciences capital expenditures grew 13% per year from 2022 to 2024, and the industry has announced more than $150 billion in new capital projects before 2030. As the McKinsey Life Sciences Practice puts it, these are “billion-dollar facilities, strict environmental controls, and enormous execution risk.” Delivery teams are increasingly managing long lead times for transformers and complex process equipment, while deploying skid-mounted, prevalidated systems that arrive on-site ready for placement. That shift moves more of the schedule risk onto the lifting program, since a delayed or mishandled pick on a prevalidated skid can set an entire commissioning sequence back.

For contractors and owner’s reps managing multiple pharma sites at once, this is also where a national accounts approach matters. Centralizing crane strategy across sites keeps equipment standards, safety practices, and points of contact consistent, which reduces the coordination burden when several plants are moving through construction on overlapping schedules.

What Cranes Are Used to Build a Pharmaceutical or Life Sciences Facility?

Liebherr LTM 1095-5.1 yellow crane on a construction site, showcasing mobility and strength.

Pharma and life sciences facility construction typically draws on three crane classes across four build phases: structural erection, process equipment and tank setting, rooftop MEP placement, and modular or skid placement. Each phase has its own lift profile, and the table below maps the phase to the crane class and why the pick is an engineered decision rather than a standard rental.

Build PhaseWhat Gets LiftedTypical Crane Class (Maxim Fleet)Why It’s an Engineered Call
Structural erection of high-bay manufacturing halls and utility buildingsTall columns, long-span membersTower cranes; crawler cranes; all-terrain cranesPicks sequenced around other trades over an expanding footprint on a compressed schedule
Large process equipment and tank/vessel settingBioreactors, tanks, process skids, transformersCrawler cranes; all-terrain cranes; hydraulic truck cranesWeight at radius plus tight final placement onto pads or structure; engineered rigging for heavy or awkward units
Rooftop and mechanical (MEP) equipment placementAir handlers, chillers, cooling towers, generators, duct modulesAll-terrain cranes; crawler cranesLong reach over an enclosed structure; repetitive sets; congested and live-adjacent sites
Modular / prefabricated placementSkid-mounted prevalidated systems, prefab MEP racks, modular cleanroom/POD unitsCrawler and all-terrain cranes; tandem (multi-crane) lifts for large modulesModule weight plus precise, low-tolerance placement; multi-crane picks require engineered lift plans

Crawler cranes have varying tonnage capacities depending on make, model, and attachments used. Maxim Crane’s crawler crane fleet ranges from 80 to 2,535 tons, which covers the heaviest structural steel and process equipment picks on a pharma build. All-terrain cranes also have varying capacities by configuration; Maxim’s all-terrain crane fleet ranges from 40 to 900 tons and moves quickly between picks on a congested, multi-trade site. Hydraulic truck cranes round out the mix for lighter, faster-moving picks, with Maxim’s fleet generally ranging from 40 to 100 tons.

How Are Large Process Equipment and Tanks Set During Pharma Plant Construction?

Bioreactors, tanks, process skids, and transformers get set using crawler, all-terrain, or hydraulic truck cranes, chosen based on the unit’s weight at radius and how far it has to travel from staging to its final pad or structural position. The challenge on these picks is rarely the tonnage alone. It is holding tight tolerances on final placement, often onto a structure that is still being finished around it, while coordinating with other trades working the same footprint on a compressed schedule.

Heavy or awkward process units, like oversized transformers or tanks with an off-center load, often call for engineered rigging rather than a standard hook-and-lift. That is a planning and equipment question that gets resolved before the unit ever arrives on site, not on the day of the pick.

What Crane Is Needed to Place Rooftop HVAC, Chillers, and Cooling Towers on a Pharma Facility?

Rooftop air handlers, chillers, cooling towers, and duct modules are typically placed using all-terrain or crawler cranes with enough reach to clear an enclosed high-bay structure. These lifts add long reach over a building shell to the list of variables, on top of the repetitive, closely sequenced sets that mechanical trades typically require.

Congested, live-adjacent construction is common on pharma sites, since MEP placement often happens while structural and interior trades are still active elsewhere on the same footprint. That makes lift sequencing, not just crane capacity, a real factor in keeping a rooftop mechanical package on schedule.

How Do Modular and Skid-Mounted Systems Get Lifted Into a Life Sciences Facility?

Modular and skid-mounted systems, including prevalidated process skids, prefabricated MEP racks, and modular cleanroom or POD units, are typically landed using crawler or all-terrain cranes, with tandem (multi-crane) lifts for the largest modules. As prevalidated, skid-mounted systems increasingly arrive on-site ready for placement, more of the schedule depends on a single, precise pick rather than an on-site assembly sequence.

Module weight combined with low-tolerance placement requirements is what makes these picks an engineered exercise. A multi-crane, tandem lift in particular requires a formal lift plan that accounts for load share between cranes, timing, and clearances, worked out well before the module arrives.

Why Crane Selection for a Pharma Build Depends on More Than Tonnage

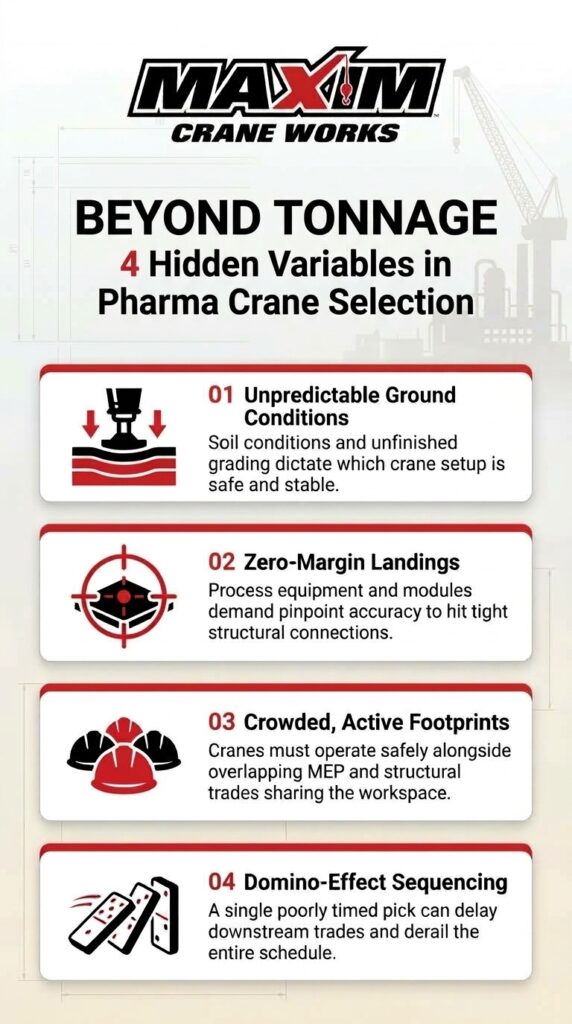

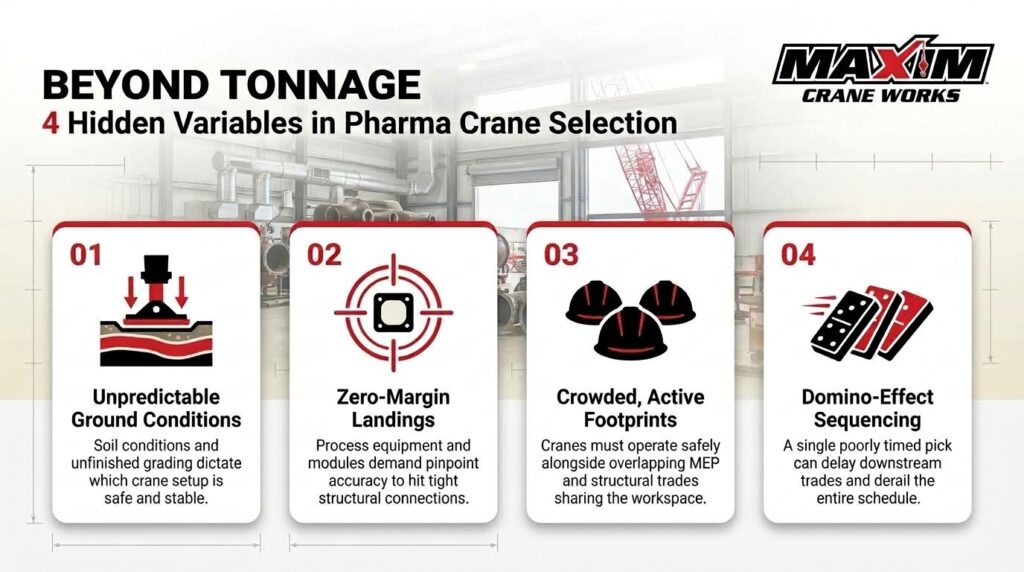

Tonnage is the starting point for crane selection, but it is far from the only variable on a pharma or life sciences build. A few factors complicate the pick on these projects:

  • Ground bearing on an unfinished site: Crane pads and outrigger placement have to account for soil conditions and site grading that may still be in progress, which affects which crane class and configuration can safely set up in a given spot.
  • Tight-tolerance final placement: Process equipment, tanks, and modular units often need to land within very narrow tolerances onto pads or structural connections, leaving little room for error on the pick.
  • Congested, live-adjacent work: Structural, MEP, and process equipment trades are frequently active on the same footprint at the same time, which means lift sequencing has to account for overlapping crews and schedules, not just crane capacity.
  • Schedule slippage from poor lift sequencing: On a multi-phase build, the order picks happen in matters as much as the equipment used. A poorly sequenced lift plan can create downstream delays that ripple through the rest of the schedule.

These are the reasons an engineering review, not a spec sheet, drives crane selection on a pharma build. A crane engineering team evaluates ground conditions, load paths, and site logistics as part of a project-specific lift plan, rather than treating the crane pick as a one-time equipment decision.

What Is Engineered Rigging, and When Is It Needed on a Life Sciences Project?

Engineered rigging is the practice of designing a custom lifting solution, beyond a standard hook-and-sling setup, for a load that is oversized, awkwardly shaped, or otherwise too complex for a routine pick. On a pharma or life sciences build, this typically comes up with large transformers, tanks and vessels with off-center loads, and multi-crane tandem lifts for modular systems.

Maxim’s engineered rigging services cover exactly this kind of work, including gantry and jack-and-slide methods for loads that a conventional crane pick cannot handle on its own. In practice, engineered rigging is where a knowledgeable lifting partner’s planning matters most: the rigging configuration, load calculations, and equipment selection all get worked out before the load ever leaves the ground.

Why a Coordinated Lift Plan Matters for Pharma Construction Schedules

A pharma or life sciences build compresses structural steel, process equipment, rooftop MEP, and modular placement into overlapping phases on a single, often tariff-driven, timeline. Sequencing that many lifts across multiple crane classes and crews is a project management exercise as much as it is a crane rental one, and getting the order wrong on one phase can push back everything that depends on it.

Long-standing partnerships bear this out. Layton Construction has worked with Maxim Crane across multiple large, multi-building projects over several years. As Senior Superintendent Mike Herrmann put it, describing the relationship: “It’s without question, you know, if you’re going to call and look for a crane, Maxim’s number one in my book.” That kind of repeat-client relationship, built on multi-year, multi-building work, reflects the same coordination pharma and life sciences programs need across a compressed build schedule.

For teams that would rather hand off the crane and crew as a single accountable unit, operated and maintained rentals pair the equipment with Maxim’s own operators for high-cycle sets like rooftop MEP or repetitive structural picks. And for owners or contractors managing more than one pharma site at a time, Maxim’s industrial crane rental experience spans exactly this kind of advanced-manufacturing megaproject, alongside a sibling build in semiconductor fab construction, which shares a similar multi-crane, compressed-schedule profile. Maxim’s guide to crane types for specialized facility builds covers how that same crane selection logic extends across data centers, fabs, and other advanced manufacturing projects.

Frequently Asked Questions About Crane Services for Pharmaceutical Facility Construction

What is the difference between crane services for building a pharma facility and installed cleanroom cranes?

Crane services for construction cover the build phase: rental crawler, tower, and all-terrain cranes used to erect structural steel, set process equipment, and place rooftop and modular systems. Permanent cleanroom overhead cranes are a separate product, stainless bridge, gantry, or workstation systems installed by equipment manufacturers for in-operation use inside a finished cleanroom.

Do rooftop MEP lifts need a different crane than structural steel erection?

Not necessarily a different class, but a different configuration. Rooftop MEP placement generally needs enough reach to clear the building shell and support repetitive, closely sequenced sets, while structural erection is often more about handling long-span members and coordinating with an expanding footprint.

What drives the cost of crane services for a pharmaceutical facility build?

Cost depends on schedule length, the crane class and size required, whether the rental is bare or operated and maintained, and whether the project needs a single crane or a multi-crane tandem lift. Site access and how many phases the crane program covers also factor in. Requesting a project-specific quote is the most reliable way to get real numbers, since these variables move the figure significantly from one build to the next.

Can one crane rental provider handle a multi-site pharma build program?

Yes. A national provider with a coast-to-coast footprint and a formal national accounts structure can standardize equipment, safety practices, and points of contact across multiple pharma sites moving through construction at the same time, rather than coordinating separate regional providers site by site.

When should a pharma project bring in crane engineering support?

As early as possible, ideally during design development rather than once construction documents are finalized. Ground conditions, load paths, and site logistics all shape which crane class and lift sequence will work, and an engineering review earlier in the process leaves more room to adjust before equipment is committed.

Construction workers walking on site with machinery in the background under clear skies.

Ready to Plan Your Pharma or Life Sciences Facility Build?

Crane services for pharmaceutical facility construction call for a partner who can match the right crane class to each build phase, from structural steel through modular placement, while keeping a compressed, tariff-driven schedule on track. Request a quote from Maxim Crane to discuss your project’s crane and lifting requirements.

Disclaimer Statement:

We hope you found this article informative. Our content is intended for general informational purposes only and does not constitute advice or necessarily reflect the range of services Maxim Crane Works, LP provides. Readers should not act upon this information without first seeking assistance from a qualified industry professional. For crane recommendations for your specific project, consider speaking with one of our sales professionals. Although we attempt to ensure that postings on our blog are complete and accurate, we assume no responsibility for their completeness or accuracy.
